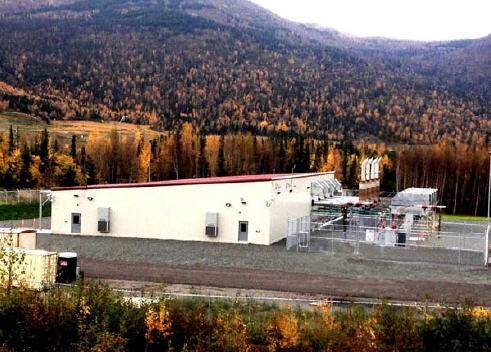

The Anchorage Landfill Gas-to-Energy Project is a partnership between the Municipality of Anchorage Solid Waste Services Department and Doyon Utilities. The project uses landfill gas, a byproduct of waste decomposition in the landfill to produce 7 Megawatts of electricity. The electricity is delivered to the Fort Richardson side of Joint Base Elmendorf Richardson (JBER).

The plant output meets the off-peak power demand for the Fort Richardson side and approximately 25% of the JBER-wide electrical demand. As the largest green energy project in the U.S. Air Force Pacific Theater of Operations, the project far exceeds renewable energy requirements for federal facilities as required by the Energy Policy Act of 2005.

The project currently operates five GE Jenbacher JGS 420 internal combustion engines. The facility is designed to ultimately house 6 units. Prior to this project, the gas was collected and burned in a flare to meet Clean Air Act standards. The landfill is expected to produce commercial quantities of landfill gas for approximately 60 years.

The project won the 2013 Silver Achievement award from the Solid Waste Association of North America (SWANA) for Landfill Utilization Projects.

Anchorage Landfill Gas to Energy Project Details

Power Plant

Engines

Jenbacher JGS 420 Landfill Gas

Plant Design Configuration

Currently 5 units with capacity for 6 units

Engine Configuration

20 cylinder internal combustion

Electrical Power Output

1,400 kilowatts per unit at 12.5 KVA

Fuel Consumption

12.3 MMBTU per hour per unit

Equivalent LFG Consumption

400 CFM at 50% Methane

Fuel Supply

Landfill Gas or Commercial Natural Gas

Emission Controls

LEANOX continuous monitoring system

Landfill Gas Processing

Blower

HSI multi-stage blowers - 2 units

Blower Capacity

2,500 CFM, 30 inches WC vacuum

Delivery Pipeline Pressure

9 PSIG

Gas Pre-treatment

Moisture removal and compression only

Landfill

Capacity

44 million cubic yards

Design Life

62 years (through 2050)

Typical Disposal Rate

1,200 ton per day; 310,000 ton per year

Total Design Footprint

165 acre, 117 currently lined

Gas Collection System

65 wells / collection points

Current Gas Production

2,200 CFM at 50% Methane

Estimated Peak Production

2,800 CFM at 50% Methane

Gas Energy Content

500 BTU/cubic foot at 50% Methane

Anticipated Commercial Gas Life

80 years

The Landfill Gas to Energy Project came on line in 2012. The initial construction cost of the project, including Gas Processing Building, gas transmission pipeline, Power Plant (5 generating units), transformers, switch gear and power line connections to Ft. Richardson grid - $31 million.
